Client
Borough of Telford & Wrekin
Location
Telford and Wrekin
Value
£5m to £10m
Duration
52 weeks

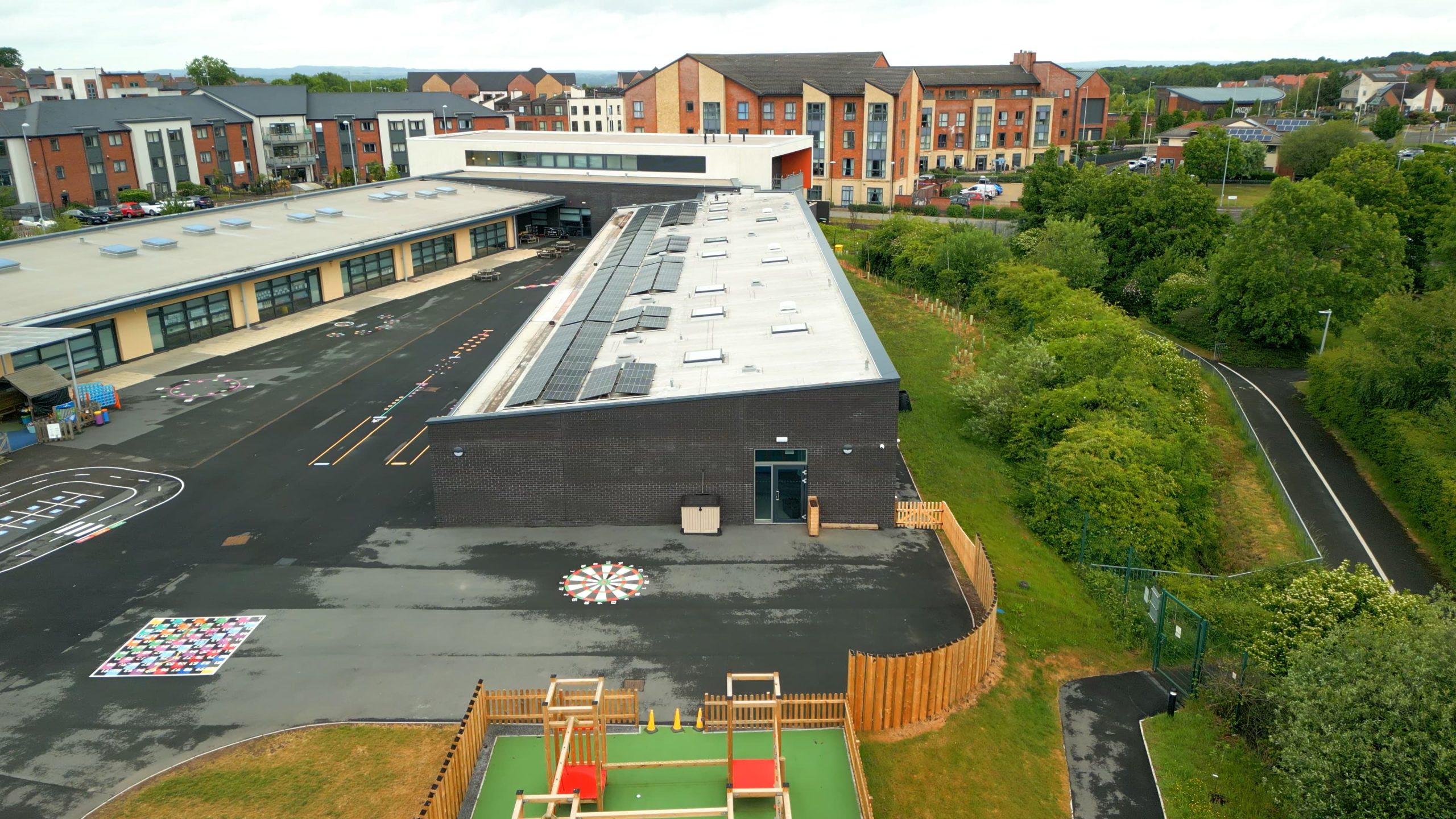

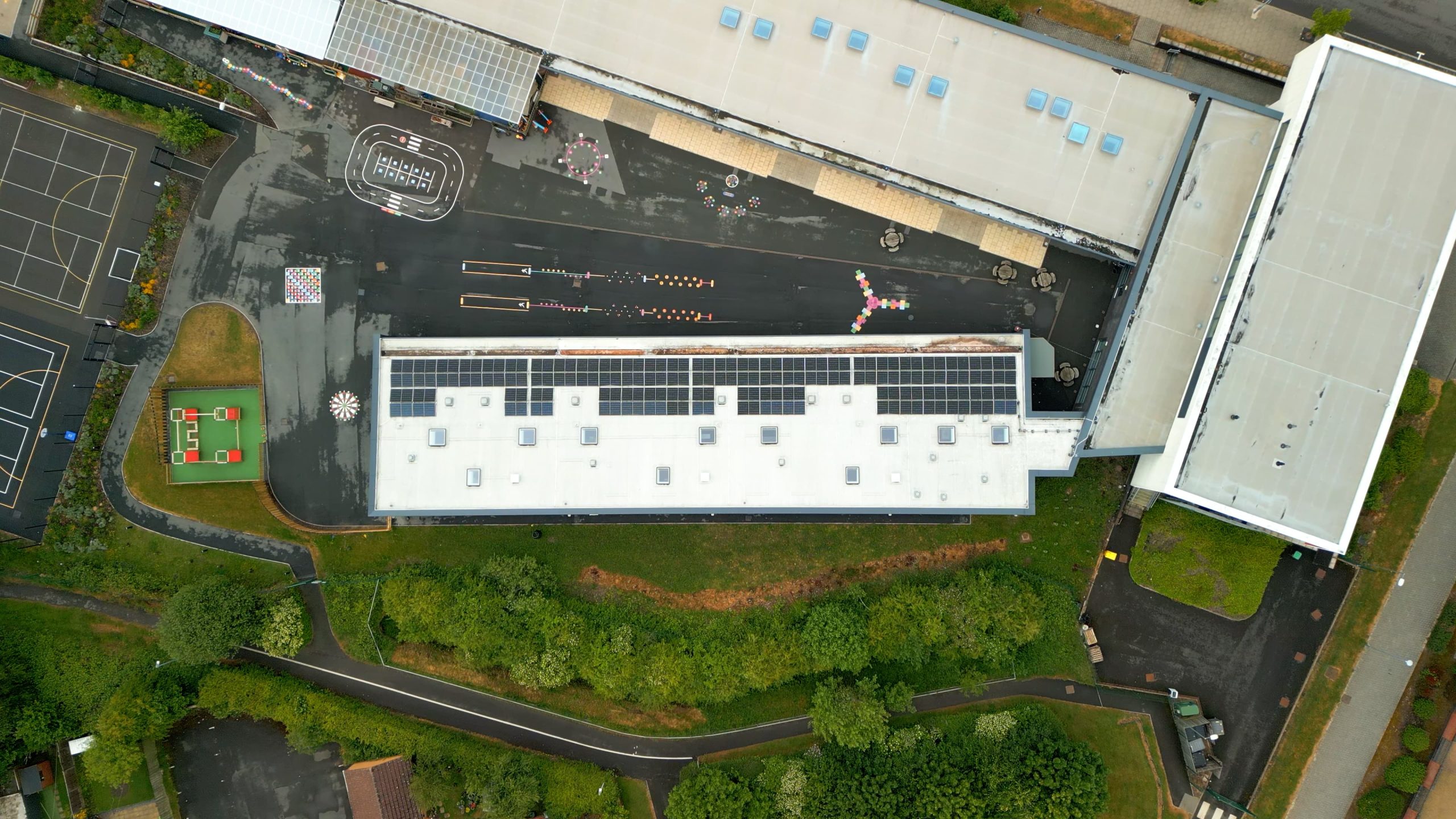

Live – Lawley Village Academy Primary School
We are currently working on expanding the existing primary school to provide over two hundred new pupil spaces with classroom and nursery places. With work starting in August ’23, we are expecting to complete the works by the end of August ’24.
August ’23 – Site setup and design team meetings.
September & October ’23 – Works to extend the existing carpark, including excavation and filling to main extension. Substructure works commence.

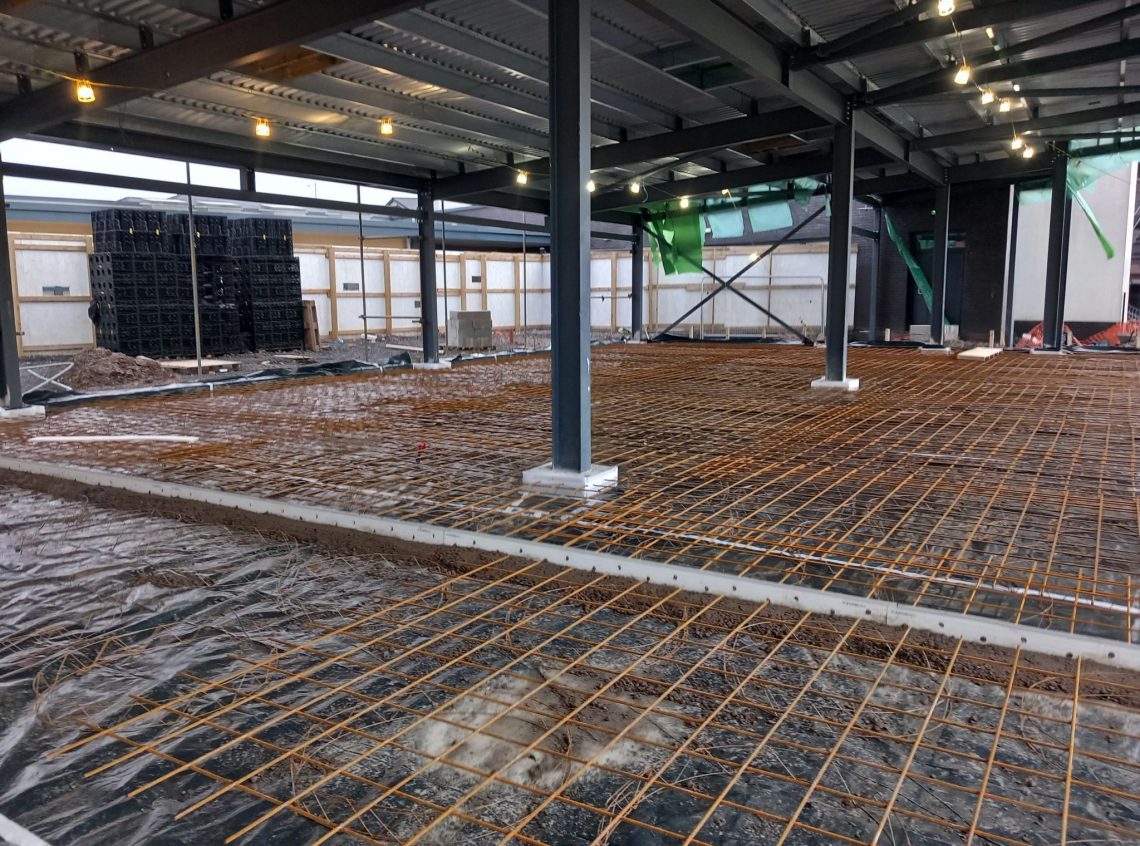

November & December ’23 – Foundations cast and brickwork started on both Nursery and Classroom bases.

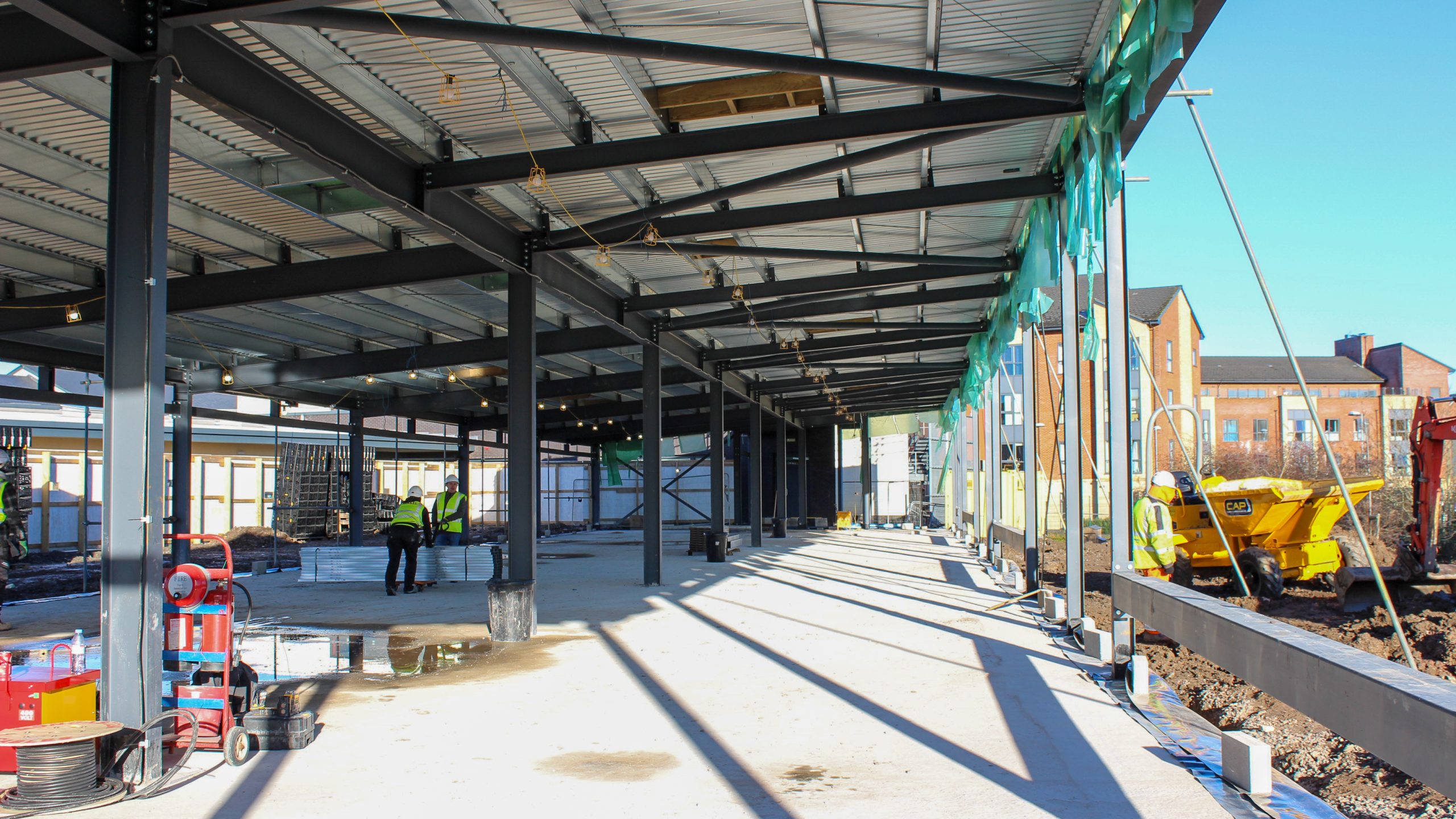

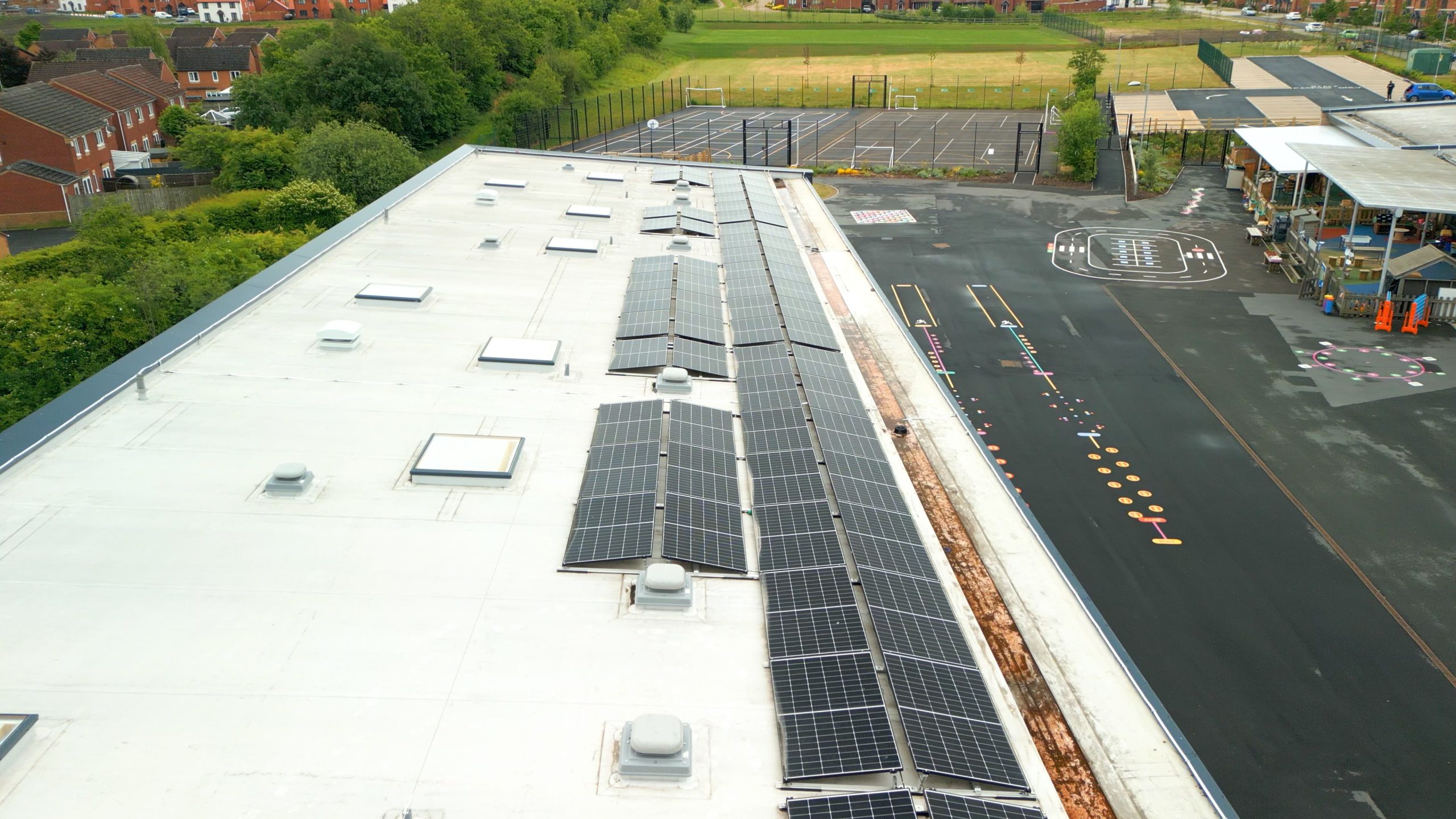

January & February – The steel framing system is installed, and the roof completed. External windows and doors are installed and masonry work commences. PV panels, mansafe system and rooflights all fitted to the main roof. Take a look at this timelapse that shows the installation of nearly 1000m2 of gas membrane and floor insulation in readiness for screeding:

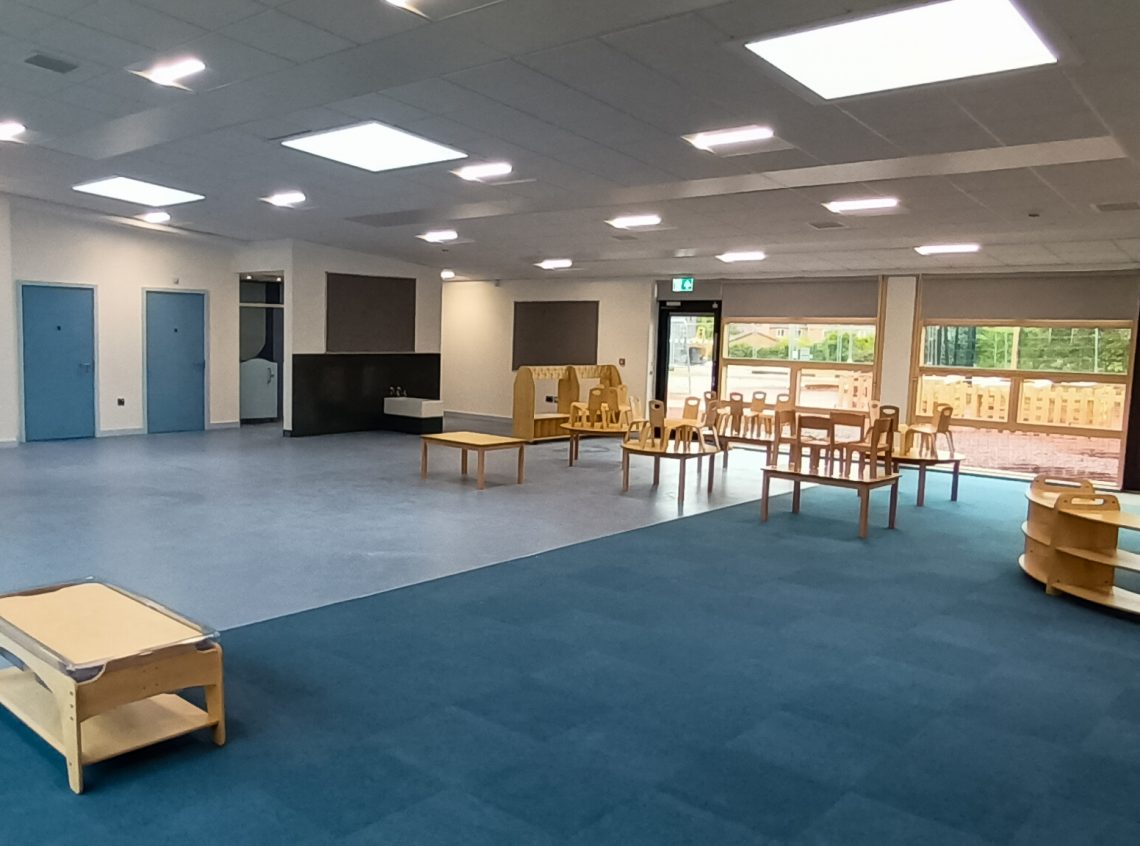

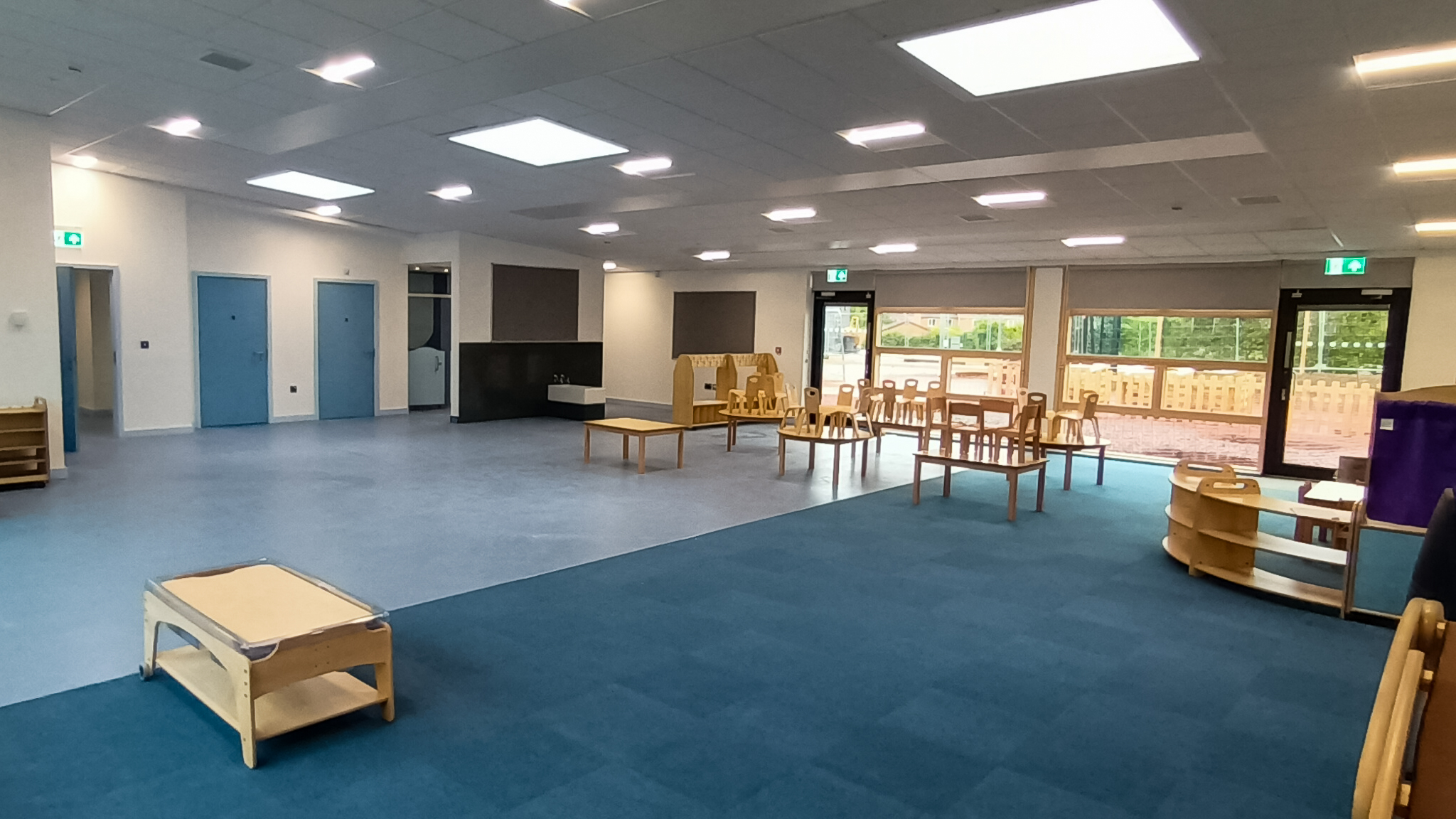

March & April – Internal walls and partitions are put up, insulation installed and M & E first fix complete. External insulated render and tarmac to the playground area are also complete – so the children can have their larger playground in time for the new term. Brickwork and groundwork continue to progress.
Keep an eye out for more updates on this page!
